Where Painting Contractors Quietly Lose Money
Every painting contractor has had that moment. The job is underway, labor hours are climbing, and someone realizes the numbers were off before the crew ever arrived. The wall area was measured correctly, but the ceilings weren't. Trim and doors were bundled instead of being broken out. The estimate assumed one coat, where the spec called for two. The project moves forward, but the margin that looked healthy at bid is shrinking with every correction.

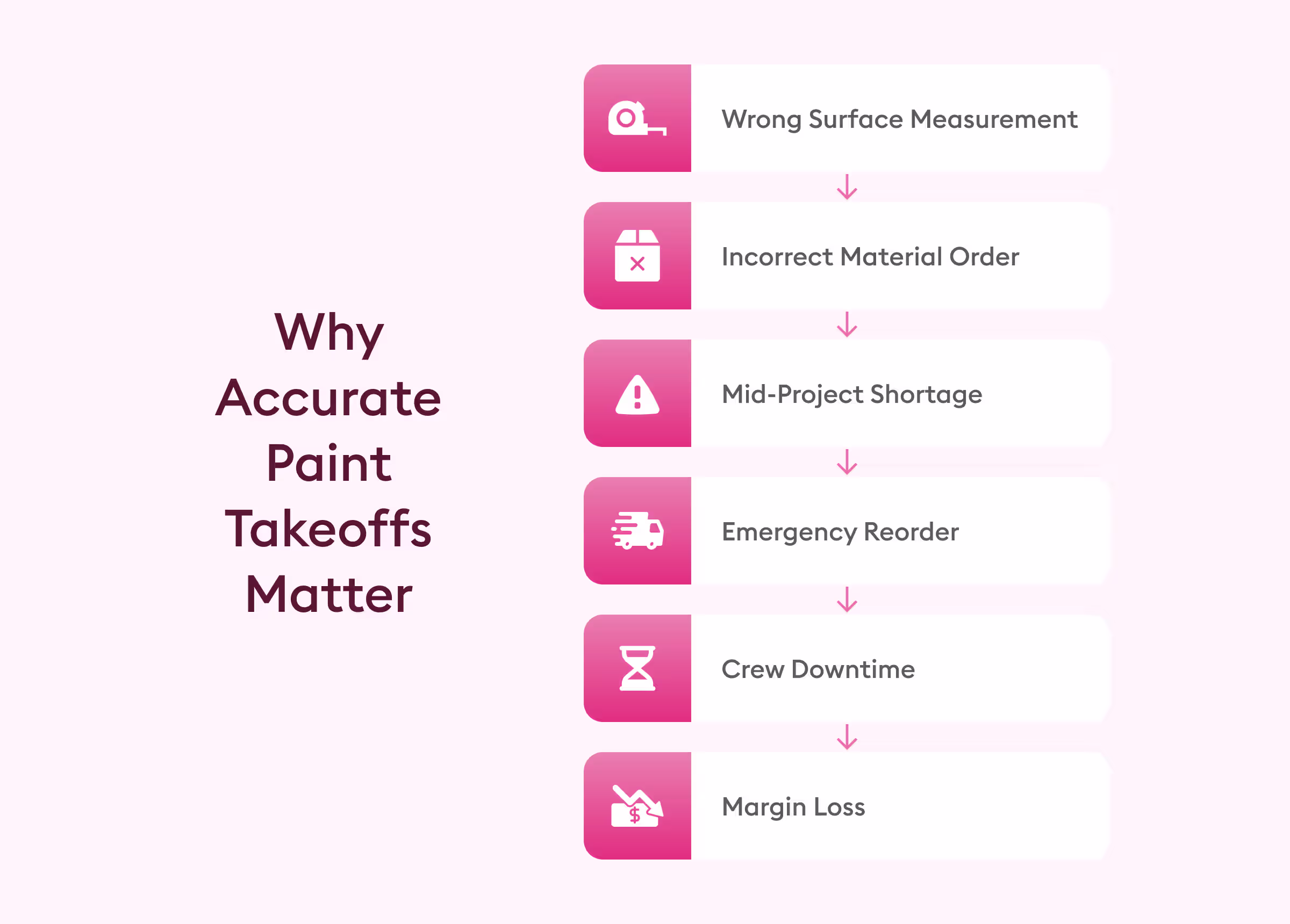

Margin loss in painting contracting starts during building estimates.
An undercounted surface, a missed coat requirement, and trim that wasn't separated from the wall area: these create cost exposure before a single gallon is opened. By the time the problem surfaces on site, the bid is locked.
That's what makes the takeoff so consequential. And for most painting contractors, it remains one of the most time-consuming parts of the process and one of the easiest places to quietly lose ground.
The U.S. painting and wall covering contractors market was valued at $28.2 billion in 2025, as reported by IBISWorld, growing at a compound annual growth rate of 3.7% over the past five years. It is a large and competitive market where profitability is closely tied to estimating discipline. The difference between a bid that protects margin and one that erodes it often comes down to how accurately the work was quantified before pricing.
All of this is to say; the takeoff is where it all begins. Getting it right is the first step.
.avif)
What is a Paint Takeoff?
A paint takeoff is the process of measuring and quantifying every paintable surface on a project to determine how much material is required, how many coats each surface needs, and the total labor cost needed to complete the job.
A paint takeoff is done during the preconstruction phase, using architectural drawings or project blueprints. When working on commercial projects, that often means reviewing plan sheets, elevations, and finish schedules to understand exactly what needs to be painted. For residential work, the process is much simpler, starting with a floor plan and a walkthrough of the property to get a clear sense of the space and scope.
What Does a Paint Takeoff Include?
A complete, accurate paint takeoff looks at every surface in the project and breaks it down clearly so nothing gets missed.
- Wall surfaces are measured using length and ceiling height to calculate total square footage.
- Ceilings are measured by room or area and are often separated from walls since they may need different coatings or labor rates.
- Trim and baseboards are measured in linear feet and then converted into surface area based on their width and profile.
- Doors are counted individually, with each side usually measured on its own.
- Windows and frames are also counted, including the area of the frames themselves.
- Specialty surfaces like columns, exposed concrete, masonry, or textured finishes are handled separately since they often require different prep or materials.
- Deductions are made for openings like doors, windows, and built-ins that reduce the total paintable area.
After everything is broken down, each item is assigned a paint type and number of coats, then pulled together into total material quantities and labor hours.
How to do a Paint Takeoff?
A paint takeoff typically follows a clear, structured sequence. Most estimation errors don’t come from the process itself but from steps being rushed, skipped, or not given enough attention under tight deadlines.
Step 1: Review Blueprints and Identify All Paintable Surfaces
Start with a full review of the drawing set before any measurements begin. This includes floor plans, reflected ceiling plans, elevation drawings, and finish schedules to build a clear understanding of the scope before anything is quantified.
Key areas to focus on:
- Room finish schedules that specify paint types, sheen levels, and coating systems
- Architectural notes that call out specialty finishes or additional primer or prep requirements
- Areas with different surface conditions, such as previously painted surfaces, raw drywall, masonry, or metal
This early review is often where scope gaps are caught. Important details are usually buried in specs or finish schedules, and they can easily be missed if this step is rushed or treated as routine.
Step 2: Calculate Wall, Ceiling, and Trim Square Footage
Once the scope is confirmed, the next step is to start taking measurements. Here’s a standard approach to follow:
- Walls: Multiply the room's perimeter by the ceiling height to determine the total wall area.
- Ceilings: For flat ceilings, use room length times width. For coffered, vaulted, or other specialty ceilings, each surface is measured on its own.
- Trim and baseboards: Measure linear footage, then convert that into surface area based on the width and profile of the trim.
Walls, ceilings, and trim should remain as separate line items throughout the takeoff. Each has its own coating requirements, number of coats, and labor rates. Combining them at this stage of the estimate only creates room for pricing errors that are difficult to isolate later.
Step 3: Account for Deductions (Doors, Windows, Openings)
Each opening in a wall reduces the net paintable area. Standard deductions include:
- Doors: Typically, 21 sq ft (3' × 7') is deducted from the wall surface area. However, the doors themselves are usually part of the painting scope. A standard door must be tracked as an addition: 21 sq ft per side equals 42 sq ft of paintable surface per door leaf, plus an additional allowance for the frame and jamb.
- Windows: Deducted at rough opening dimensions
- Large built-ins or millwork: Deducted for the surface area covered by fixed cabinetry or furniture
Deduction methods can vary from estimator to estimator. Some apply full deductions for every opening. Others apply them only beyond a minimum threshold. Whatever the approach, the important thing is to stay consistent across the entire project and thoroughly document each step so anyone reviewing the estimate can easily follow the logic.
Step 4: Factor in Coats, Surface Type, and Spread Rate
Square footage by itself does not determine how much material is needed. Two key factors also need to be considered.
Number of coats: New drywall usually needs a primer coat followed by two finish coats. Surfaces that have already been painted and are in good condition may only need one coat. Significant color changes, such as going from dark to light or light to dark, often require additional coats as well.
Surface Porosity and Spread Rate: Each paint product has a theoretical spread rate (square feet per gallon) listed on its technical data sheet. However, surface texture drastically impacts actual coverage.

- Smooth Drywall: Usually achieves a high spread rate of 350–400 sq. ft./gallon.
- Porous Masonry/CMU: Easily absorbs paint, dropping the spread rate to 100–150 sq. ft./gallon.
- Wood/Stucco: Typically averages 200–250 sq. ft./gallon.
Dry Film Thickness (DFT)
Commercial projects often specify a required Dry Film Thickness, measured in mils (thousandths of an inch). When a higher DFT is required for durability, the paint has to be applied more heavily or built up with additional coats, even if that goes beyond the manufacturer’s standard spread rate.
Total paint volume is calculated as follows: (Net Square Footage x Number of Coats) divided by Spread Rate = Gallons Required
This calculation is done separately for each surface type and each coating product used in the project.
.avif)
Step 5: Compile Paint Quantities and Apply Waste Factor
Once all surfaces have been measured, the quantities are combined into a single material summary. From there, the materials are organized by product type, sheen, and color. A waste factor is then added to account for material lost, whether it is absorbed by roller covers, left behind in containers, used for touch-ups, or lost during application.
Waste factors should scale based on how the paint is being applied:
- Brush-and-roll jobs carry a waste factor of 5-10% that is to be expected.
- Spray applications tend to carry a higher waste factor of 15–20% (or more) due to overspray loss and equipment priming.
The final quantity summary outlines the total gallons required by product type (e.g., drywall primer, interior eggshell, exterior semi-gloss). This allows contractors to quickly price materials using supplier quotes and keep costs aligned with the project budget.
Step 6: Calculate Labor Costs Based on Production Rates and Crew Size
Labor is normally the highest single cost on a painting bid and is one of the most difficult to estimate. How much a crew can do in an hour is determined by the surface, the coating, and the amount of preparation. For instance, rolling a smooth drywall surface is much faster than applying coatings to rough masonry.
That’s why production rates matter. Contractors use them to estimate how many labor hours a job will take based on crew size and working conditions. Once they build their estimate, they apply hourly labor costs that include payroll taxes, insurance, and other overhead expenses. Prep work also needs its own estimate. Sanding, patching, caulking, and surface repairs: all of these processes can take a great amount of time, which is often separate from the actual painting job itself.
Common Paint Takeoff Formulas Contractors Use
Manual, Software, or AI Takeoffs: Which Should Painting Contractors Use?
The right approach depends on bid volume, project complexity, and how much estimator time can be allocated to measurement versus review and strategy. Each method carries different trade-offs.
When Manual Still Makes Sense
For small residential repaints with simple geometry and no blueprints, manual takeoffs are usually enough. The scope is manageable, the calculations are fairly straightforward, and using software may not add much practical value.
But once blueprints enter the picture, the scope becomes more detailed, or bid requests start coming in regularly, manual methods begin to slow things down. At that point, they can start limiting both how quickly estimates get completed and how accurately they’re put together.
When It's Time to Move Beyond Spreadsheets
Manual takeoffs eventually put a cap on how much estimating work a team can handle. Most contractors hit that limit sooner than expected, and when they do, it shows up directly in revenue.
Indicators that manual or basic digital takeoffs are limiting revenue include:
- Takeoffs taking 3 or more days per project
- Bids are being declined due to limited estimating capacity
- Cost overruns traced back to quantity errors
- A need to grow bid volume without increasing headcount
These are the conditions under which AI-based painting estimating software delivers a measurable return.
How AI Is Changing Painting Estimating
For most painting contractors, estimating capacity is not limited by the amount of work available. It is limited by the time it takes to complete each takeoff. When a single takeoff can take 3 to 5 days of manual effort, the number of bids a team can handle depends more on time than opportunity.
The Estimating Bottleneck Is a Business Constraint
Manual takeoffs quietly put a ceiling on how many bids a contractor can pursue each month. Estimators spend hours going through plans, measuring walls, ceilings, trim, finishes, and everything else needed before pricing can even begin.
As bid requests start piling up, many contractors hit a point where they simply can’t keep up with every opportunity coming in. Not because the work is missing, but because the estimating workload becomes too heavy to keep up with.
AI helps by taking a large portion of the manual measurement work off the estimator’s plate. Instead of spending days stuck in takeoffs, estimators can focus more on the parts of the job where experience and judgment actually matter. That includes reviewing scope, validating quantities, coordinating pricing, and building stronger, more competitive bids.
What This Looks Like in Practice
Pro Works Painting faced this exact constraint as its bid volume grew. At a certain point, the estimating team no longer had enough bandwidth to chase every opportunity, so they had to become more selective about what they pursued.
After adopting Beam AI, the time spent on manual takeoffs dropped significantly. What used to take around 20 to 30 hours per project was no longer tied up in measurement work. That change gave estimators more room to focus on the parts of the job that actually move projects forward, refining pricing, and spending more time talking with clients instead of getting buried in detailed takeoff work.
The Impact
The biggest shift was not just speed but also capacity. Pro Works Painting increased bid capacity by 15x. That is what AI-based estimating tools like Beam AI make possible: they function as AI painting estimators within the workflow.
With more consistent and complete estimates, teams can make better pricing decisions, which improves win rates and margins alongside higher bid volume.
In Closing
A paint takeoff is the document on which a project's profitability either holds up or breaks down. Contractors who approach it with discipline and prioritize accuracy reduce the time it requires, prevent it from becoming a constraint on growth, and are better positioned to win more work and protect their margins on every project they take on.
Manual takeoffs served their purpose. Digital takeoff software advanced the process. AI-powered painting estimating is where the structural shift is occurring.
The industry is moving in this direction. The question is how many bid cycles pass before that advantage becomes part of your operation.
