5 Steps to Estimate a Lumber Takeoff

5 mins read

May 24, 2026

Takeoff Software
Blogs

>

Takeoff Software

>

Key Takeaways

  • A lumber takeoff quantifies every framing material, including studs, headers, plates, and sheathing, before a single board is ordered.
  • Accurate framing takeoffs prevent over-ordering, under-ordering, and the budget overruns that follow either.
  • Five core steps cover everything from rough sketches to sheathing calculations, and each one builds on the last.
  • Manual lumber estimation is slow, can cause errors, and is difficult to scale across multiple bids.
  • AI-powered takeoff software automates the entire process, delivering accurate quantities in a fraction of the time.

Summary

This step-by-step guide walks you through the five steps to estimate a lumber takeoff, along with the common mistakes that derail estimates and how AI-powered takeoff software like Beam AI automates the process to improve speed and accuracy.

Key Measurements in a Lumber Takeoff

Before running calculations, you need to know exactly what it is that you are measuring. A lumber takeoff is a type of material takeoff, and like any other material takeoff, it mainly consists of four standard measurement parameters. Each one applies to different framing components and drives a different part of the material list.

Book a personalized demo

See how Beam AI fits into your estimating workflow. Get a tailored walkthrough based on your trade, project volume, and current takeoff process.

Schedule a demo →

Dimensions

Used to determine the length of individual framing pieces, including joists, studs, beams, and plates. Dimensions help estimators determine how many full-length boards are needed and what standard lengths to order. For example, if a project requires 9-foot studs, 10-foot boards may need to be ordered and cut down, since 8-foot boards would be too short.

Count

Refers to the number of individual components required, including items like studs, headers, posts, fasteners, joist hangers, and nails. These are measured by per-unit rather than area or length. Even a small error in counts, especially in hardware or fasteners, can cause a significant impact on the total material requirements.

Area

Used for surface materials such as wall sheathing, roof decking, and subfloor panels. Area is calculated in square feet and then converted to sheet count (each 4x8 panel covers 32 sq ft). The measurements also apply to any surface material that gets installed continuously across a face.

Volume

Less common in lumber takeoffs but important for certain structural elements, such as piers, footers, or large timber posts. Volume is expressed in board feet and calculated using the formula: (thickness in inches x width in inches x length in feet) / 12. It is mainly used for pricing and bulk procurement of dimensional lumber.

One important thing to remember is that using the correct measurement type for each item is just as important as getting the quantity right. Misclassifying a component, such as counting studs in linear feet or calculating sheathing in board feet instead of sheets, can result in a material list that’s simply unusable.

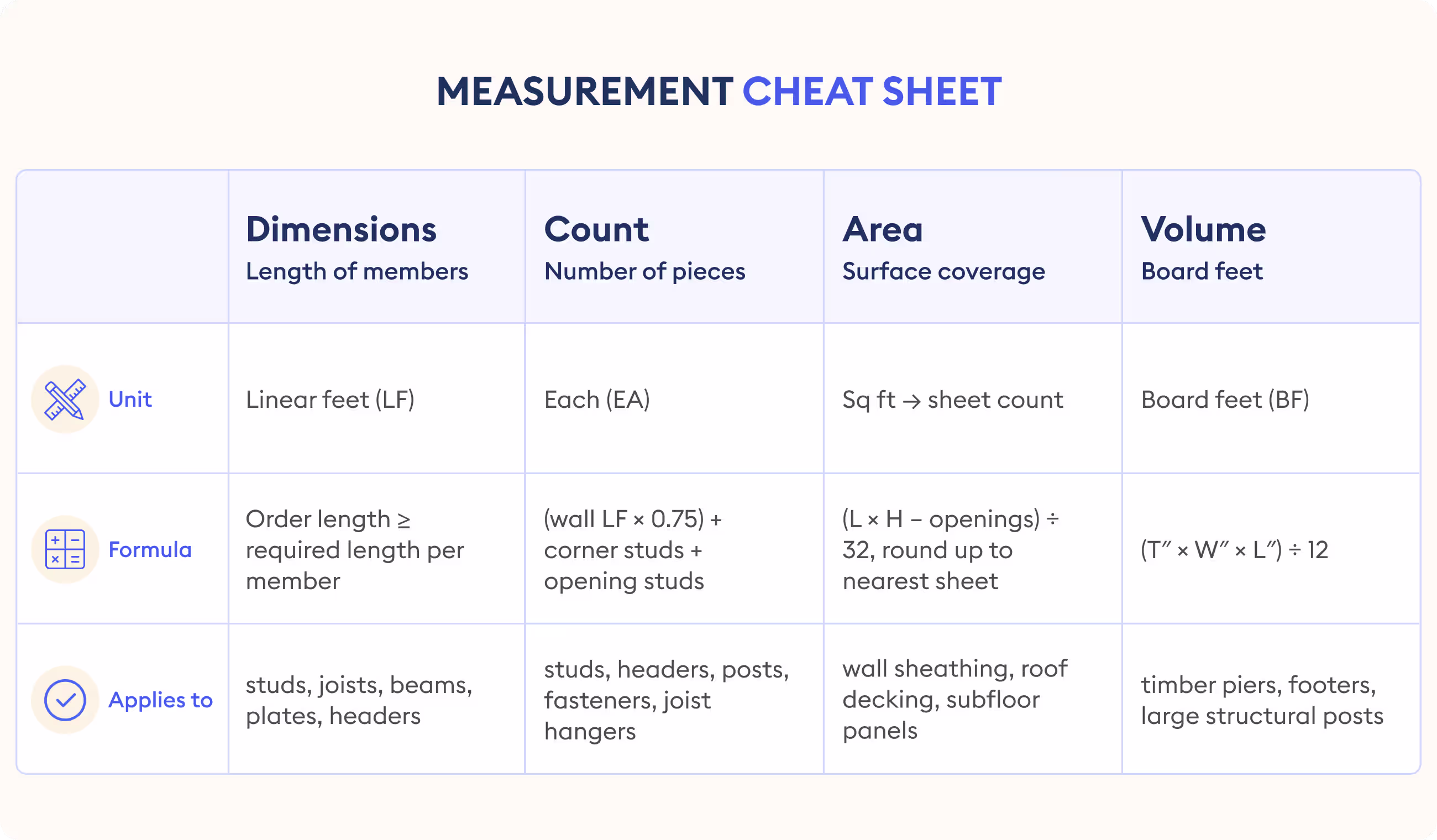

measurement cheat sheet - lumber takeoff

Step-by-Step Guide: How to Estimate a Lumber Takeoff

The process of performing a lumber takeoff is similar to any quantity takeoff. You work through a defined sequence, measure each element against the drawings, and build a complete material list. The five steps below follow the same sequence most experienced estimators go by. Each step builds on the step before it, so skipping or rushing any part only leads to bigger inaccuracies later on.

Lay out a rough plan/sketch

Start by performing takeoffs from a set of construction plans or drawings. If you do not have a formal plan set, create a rough sketch that identifies wall sizes, door openings, window openings, and wall stud locations. Note the spacing between studs and the points where walls intersect. This gives you the base reference for every calculation that follows.

Calculate the number of studs needed for the job

Measure the wall length in feet and multiply by 0.75 to get your base stud count. Then add studs for corners: 3 studs for each 90-degree corner, and 4 studs for each 45-degree corner.

For openings, apply the following:

  • Openings less than 5 feet wide: add 2 studs per opening
  • Openings more than 5 feet wide: add 1 stud per opening

Once you have your total, apply a 15% wastage factor to the final count.

Estimate the header materials

For standard door and window sizes, headers are typically built from two 2x12 timber pieces, with a half-inch-thick plywood piece cut to the same size, sandwiched between them.

To calculate header material:

  • For door openings: add 7 inches to the total opening size to get the header length
  • For wall frame thickness: add 3.5 inches to the width or depth of the opening for a 2x4 wall frame

Apply this calculation to each opening individually. Header sizes vary with span and load, so always verify against the structural drawings rather than assuming a standard size for all openings.

Calculate supporting plates

For load-bearing walls, account for a single bottom plate and a double top plate. To calculate total plate length, multiply the wall length by 3.

Total plate length = Wall length x 3

Add a wastage factor of 5 to 10 percent to the final plate length to account for cuts and splices on site.

Estimate sheathing

Estimate sheathing

Calculate the wall area by multiplying the wall length by the wall height, then subtracting the area of any openings. Divide the result by 32 (the coverage of a standard 4x8 panel) and round up to the nearest whole number. This gives you the total sheet count for one wall face.

Sheet count = (Wall length x Wall height - Opening areas) / 32, rounded up

Run the same calculation for each wall face separately. Apply a 10 percent wastage factor for cuts and damaged panels, and calculate roof sheathing and floor decking as separate line items if they fall within the project scope.

Common Mistakes to Avoid During Lumber Takeoff

Most lumber estimation errors can be traced back to a few, very commonly made mistakes. Once you are able to identify them clearly, it only becomes easier to eliminate them as you go on.

Working from outdated drawings

This one’s easily one of the most common preconstruction errors made today. It can also make the project suffer greatly, cost-wise. Never run a takeoff from a superseded drawing set. Always verify if you’re working with the current version before beginning any measurement.

Ignoring waste factors

Lumber is cut on site, and every cut produces offcuts that are rarely reusable for structural framing. Therefore, a takeoff that doesn’t account for waste will consistently understate material requirements.

Treating all walls the same

Exterior walls, load-bearing walls, and partition walls all come with different requirements when it comes to stud spacing, plate counts, and headers. If you try to apply the same calculation method to every wall type, the quantities will quickly end up being inaccurate.

Skipping the scope review

A lumber takeoff done without going through the full drawing set, be it structural, architectural, or any addenda, is almost certain to miss important items. That’s why a proper scope review at the very beginning is so important, and it’s not something that should be skipped.

Read success story

Learn how contractors are increasing bid output, reducing rework, and improving win rates with more accurate takeoffs and faster workflows.

Explore success stories →

How to Improve Your Lumber Takeoff

Accuracy and speed are often treated as a trade-off, but they don’t have to be. Both can be achieved at the same time. It all comes down to two things: having a structured process for lumber estimation and using the right tools. Here are a few practices to adopt that can make a measurable difference today:

Standardize your takeoff sequence

Run every takeoff in the same order, such as perimeter walls, interior walls, headers, plates, and sheathing. Having a consistent sequence like this reduces the risks of omissions and makes the document easier to review.

Use a material list template

Using a standard template with preset line items helps keep takeoffs consistent from one project to the next. It makes it easier to avoid missing scope items, compare different jobs side by side, and refer back to past estimates when checking costs or pricing trends.

Build in a review step

Going back through the completed takeoff a second time can help catch mistakes that were missed during the initial review. On larger or high-value bids, having another estimator review the quantities is also a fairly common practice.

Track actuals against estimates

Once the project is finished, it helps to compare the estimated quantities against the actual material usage on site. Looking at those differences can reveal where the estimate was off and make future takeoffs more accurate over time.

Adopt takeoff software

Manual takeoffs can only move so fast, and accuracy often depends heavily on the person who is actually doing the work. Software tools, especially AI-based platforms like Beam AI, help simplify a lot of that process by automating measurements, reducing common manual mistakes, and making it easier to turn around complex bids faster.

Manual Lumber Takeoff Vs AI Lumber Takeoff Software

Whether you’re producing lumber takeoffs manually or taking the help of AI-powered software, the goal remains the same: to produce a material list with quantities. The difference simply lies in how long it takes, how accurate the result is, and how scalable the process is, particularly when bid volume increases. Here’s how both of them compare:

Factor Manual Lumber Takeoff AI Lumber Software
Speed Slow and time-intensive; requires manual measurement of every component Fast; automates measurement and quantity extraction
Accuracy Prone to human error, especially in complex drawings High accuracy and less manual calculation errors
Consistency Varies by estimator and experience level Standardized output across projects
Scalability Difficult to scale for large or multiple projects Easily handles large-scale and high-volume takeoffs
Revision Handling Requires rework when drawings change Updates can be processed quickly with less manual effort
Audit Trail Notes and marked-up prints Full digital record linked to drawings
Cost Impact Higher risk of costly mistakes and overruns Helps reduce waste and improve cost predictability
Collaboration Harder to share, review, and standardize outputs Easier sharing, tracking, and team collaboration
Turnaround Time Longer bid preparation cycles Faster bid turnaround and response times

Why Estimators Are Switching to AI-Powered Takeoff Software

Manual lumber estimation has a hard ceiling on both speed and accuracy. AI-powered takeoff software like Beam AI removes that ceiling entirely. Estimators using Beam AI recover up to 90% of the time previously spent on manual takeoffs—time that goes back into bid strategy, supplier coordination, and project review.

Beam AI's cloud-based platform means multiple team members can work on the same takeoff simultaneously. Quantities update in real time, everyone works from the same current data, and the back-and-forth of versioned spreadsheets disappears.

Key Benefits:

Increased productivity: Beam AI automates the measurement and counting tasks that consume the bulk of estimator time. That frees your team to focus on what actually wins jobs, i.e., accurate pricing, supplier negotiations, and bid review.

Fewer errors: Automated identification and measurement of lumber elements removes many of the manual steps where mistakes typically occur. The process remains consistent each time, producing reliable results regardless of who performs the takeoff.

Real-time collaboration: Because Beam AI is cloud-based, your entire team works from a single live source. Updates are visible instantly, coordination gaps close, and the risk of working from an outdated material list is eliminated.

Final Thoughts

A lumber takeoff is more than just counting materials off a drawing. It involves going through the plans carefully, measuring each component properly, and making sure every wall type, opening, and framing condition is accounted for.

The five steps covered in this guide follow the same approach most estimators use in practice. It starts with sketch and scope review, then moves through stud calculation, header estimation, plate calculation, and finally sheathing quantities. Each step builds on the one before it, helping reduce the kind of small errors that can add up later.

Manual estimation can still get the job done, but it takes time, doesn’t scale easily, and leaves room for mistakes when most of the calculations are being done manually.

AI-powered lumber takeoff tools help reduce those friction points by bringing more structure to the process, automating measurements, and keeping outputs consistent. The workflow itself doesn’t change, but it becomes faster, easier to repeat, and simpler to review.

As bid volume grows, the question isn’t just whether manual construction takeoffs work but how much time they consume and what could be saved by using a system like Beam AI in the estimating process. If you are ready to transform the way your team handles lumber takeoffs, then go ahead and book a demo today.

SHARE TO

Riya Trehan

Senior Analyst - Product & Content

About Author

Riya is a construction-focused writer who brings a sharp editorial eye and deep industry knowledge to clear, purposeful writing.

About Author

The Ultimate Guide to Construction Cost Estimating

Download eBook →

FAQs

What is included in a framing takeoff?

Chevron down blue

A framing takeoff is a full breakdown of all the lumber and panel materials needed to build a structure’s frame. This usually covers things like wall studs, top and bottom plates, headers, rim boards, blocking, posts, beams, and sheathing (OSB or plywood). In some cases, depending on the scope, it may also include hardware like joist hangers and other structural connectors.

Why is lumber takeoff important?

Chevron down blue

Lumber takeoff determines the quantity of material to procure before construction begins. An accurate takeoff prevents over-ordering, which inflates project cost, and under-ordering, which causes project delays. It is also the basis for subcontract pricing, supplier negotiations, and project budget control.

Can lumber takeoff be automated?

Chevron down blue

Yes. AI-powered takeoff software, such as Beam AI, helps in automating the entire lumber takeoff and estimation process. Instead of measuring everything by hand, the software reads digital construction drawings, identifies framing components, calculates material quantities, and organizes the results into formats that are compatible with common estimating tools, allowing estimators to save time and reduce manual errors.

Which software solutions are best for residential framing takeoffs?

Chevron down blue

Ideally, the best residential framing takeoff software should do more than just pull quantities from drawings. It should understand how lumber is actually measured and used in the field. Beam AI is built for this use case, handling stud counts, plate footage, header schedules, and sheathing calculations from uploaded PDF plans, with QA review included.

What is the best lumber takeoff software?

Chevron down blue

The best lumber takeoff software should make estimating easier and faster and not create more bottlenecks. It should be able to directly pull measurements from plan drawings, keep track of revisions, and export quantities in a format that integrates smoothly with your existing estimating workflow. Beam AI meets all three criteria and is used by framing contractors and GCs across the US and Canada.

Is there any free lumber takeoff software available?

Chevron down blue

While there are platforms that offer limited free tiers, they often come with limitations. Features like automation, revision tracking, and trade-specific measurement logic are often missing, which means more manual work and higher chances of mistakes. For contractors managing multiple bids, the time spent fixing errors and rechecking quantities can end up costing far more. Therefore, the more practical option is to invest in software that is specifically built for this job.

What is lumber yard takeoff software used for?

Chevron down blue

Lumber yard takeoff software is used by suppliers and distributors to generate material lists from contractor-provided plans. It allows lumberyards to produce accurate quotes from project drawings rather than relying on contractor-supplied quantity lists, reducing quoting errors and speeding up the procurement process.

Which software is best for framing material lumber takeoffs?

Chevron down blue

Beam AI is a practical option for lumber takeoffs, especially for teams handling a steady flow of residential or commercial projects. Instead of manually measuring framing plans, the platform reads the drawings, pulls out lumber quantities, and organizes the information into formats estimators can work with right away. Most takeoffs are turned around within 24 to 72 hours, depending on how large or detailed the project is.

What is the best lumber takeoff software for residential construction?

Chevron down blue

For residential construction, the best lumber takeoff software automates stud, plate, header, and sheathing calculations from PDF plan sets and delivers results fast enough to support competitive bid timelines. Beam AI's AI-based platform is purpose-built for this workflow and is used by residential framing contractors managing high bid volumes.

Latest Articles

Mechanical Takeoffs Explained for Contractors and Estimators

Takeoff Software

5 mins read

Mechanical Takeoffs Explained for Contractors and Estimators

Muskaan Sharma

&

Read blog →

A Practical Guide to Choosing HVAC Estimating Software

Construction Estimation

5 mins read

A Practical Guide to Choosing HVAC Estimating Software in 2026

Ura Verma

&

Read blog →

How AI and Automation Are Transforming Construction Estimating Workflows

Construction Estimation

5 mins read

How AI and Automation Are Transforming Construction Estimating Workflows

Natasha Ao

&

Read blog →

Experience the Best Takeoff Software for Estimators

Talk to us and get your first AI takeoff done at no cost!

Get a Step-by-Step Beam AI Walkthrough
