Why Concrete Pouring Fails Inspection (and What It Costs You)

3 mins read

August 25, 2026

Insight
Blogs

>

Insight

>

Key Takeaways

  • Concrete pouring inspection failures often come down to the same six areas: formwork, reinforcement, subgrade prep, mix design, MEP embedments, and equipment or weather planning.
  • A failed concrete pouring is never a single cost. Standby fees, tear-out, and re-pour labor usually cost less than the schedule slip that follows.
  • Dry pour concrete does not pass structural inspection and should never be substituted for a properly batched wet mix on a permitted pour.
  • Rebar cover and slump requirements are set by code. They are not based on what looks right on site. A mix or placement can look fine and still fail to meet the required standards.
  • Accurate concrete takeoff software and concrete estimating software catch thickness, reinforcement, and volume errors before bid day, well before they become a failed hold point in the field.

Summary

Concrete pours rarely fail because of bad luck. They fail because something underneath was missed. This blog breaks down six key checkpoints, what can go wrong at each one, and how a simple pre-pour check can help avoid costly surprises.

The High Price of a Failed Concrete Inspection

A failed pour is never a line item. The costs appear in three places at once, and the second and third are usually more expensive than the first.

  • Direct financial losses: standby fees for ready-mix trucks, wasted batch material, and tear-out and demolition costs on the rejected section.
  • Project delays and schedule slippage: idle crew labor, missed milestone dates, and downstream trades that cannot start until the corrected pour cures and re-passes.
  • Regulatory and legal penalties: stop-work orders, failed entries in the special inspection log, reduced structural load ratings on the affected element, and insurance or bonding compliance risk.

Industry research on field rework shows how quickly this cost adds up. A peer-reviewed analysis summarized by the American Society of Civil Engineers found that actual rework costs on completed projects are higher than contractors usually report.

The cost goes up even more when you include problems found after the project is finished. Concrete placement is one of the most common triggers behind that number, since it sits on the critical path of nearly every structure.

Book a personalized demo

See how Beam AI fits into your estimating workflow. Get a tailored walkthrough based on your trade, project volume, and current takeoff process.

Schedule a demo →

Top 6 Reasons Concrete Pours Fail Inspection

Improper Formwork Setup and Bracing

Formwork problems usually have little to do with the concrete pouring itself. They often start with the structure holding the concrete in place before it sets.

  • The issue: unstable formwork, incorrect dimensions, unsealed gaps that leak slurry, or insufficient lateral bracing that risks a blowout under hydrostatic pressure once the concrete pouring process starts.
  • What inspectors look for: form alignment against the drawings, elevation accuracy, cleanliness inside the forms, and structural integrity of the bracing system under load.

Rebar and Reinforcement Violations

Reinforcement is one of the first things checked during a pre-pour inspection, and that too quite thoroughly. It’s also easy to get it wrong when the schedule is tight.

  • The issue: incorrect bar sizing or spacing, improper lap splice lengths, missing rebar chairs that leave insufficient concrete cover, or oily and dirty bars that degrade bond strength with the surrounding concrete.
  • What inspectors look for: enough clearance from the subgrade, secure tie wires at each intersection, and rebar that matches the approved structural drawings. Cover depth depends on the exposure conditions. For concrete that is placed directly against soil, the  American Concrete Institute's structural concrete building code requires at least three inches of cover.

Poor Subgrade Preparation

Everything placed on top of a bad subgrade inherits its problems, and those problems usually surface months after the pour, not during it.

  • The issue: uncompacted subgrade, standing water, mud, or unaddressed expansive soils that lead to future slab settlement and cracking.
  • What inspectors look for: soil compaction test reports, correct vapor retarder placement, and clean, dry ground conditions immediately before the concrete pouring begins.

Subgrade condition also determines which slab type and thickness are appropriate for the application. A thickness that works on a well-compacted, low-moisture subgrade can underperform badly on soil that was never tested or corrected.

Subpar Concrete Mix Design and Slump Issues

This is where a lot of avoidable concrete pouring problems begin to surface and where time pressure can make shortcuts feel tempting.

  • The issue: The quality of concrete can change before it even reaches the pour. For instance, if a batch truck arrives past its agreed discharge window, extra water may be added on-site to make the mix easier to place or a mix that does not match the specified PSI for use. The old ASTM rule restricted discharge to 90 minutes once batching is complete. In 2021, that was changed to a time limit agreed on by the buyer and producer, as per the American Concrete Pumping Association. Either way, a load that sits too long or gets watered down on arrival no longer matches the mix design that was specifically engineered for the pour.
  • What inspectors look for: batch tickets, slump tests against the specified range, temperature monitoring, and air-entrainment levels.

Dry pour concrete belongs in this category too, though it rarely reaches a formal inspection at all. Dry pour, or dry-pack, placement skips mixing water in beforehand and instead adds it from the top of the form. Hydration ends up uneven, strength falls well short of what a wet-mixed pour reaches, and most inspectors will not sign off on it for anything that requires a permit.

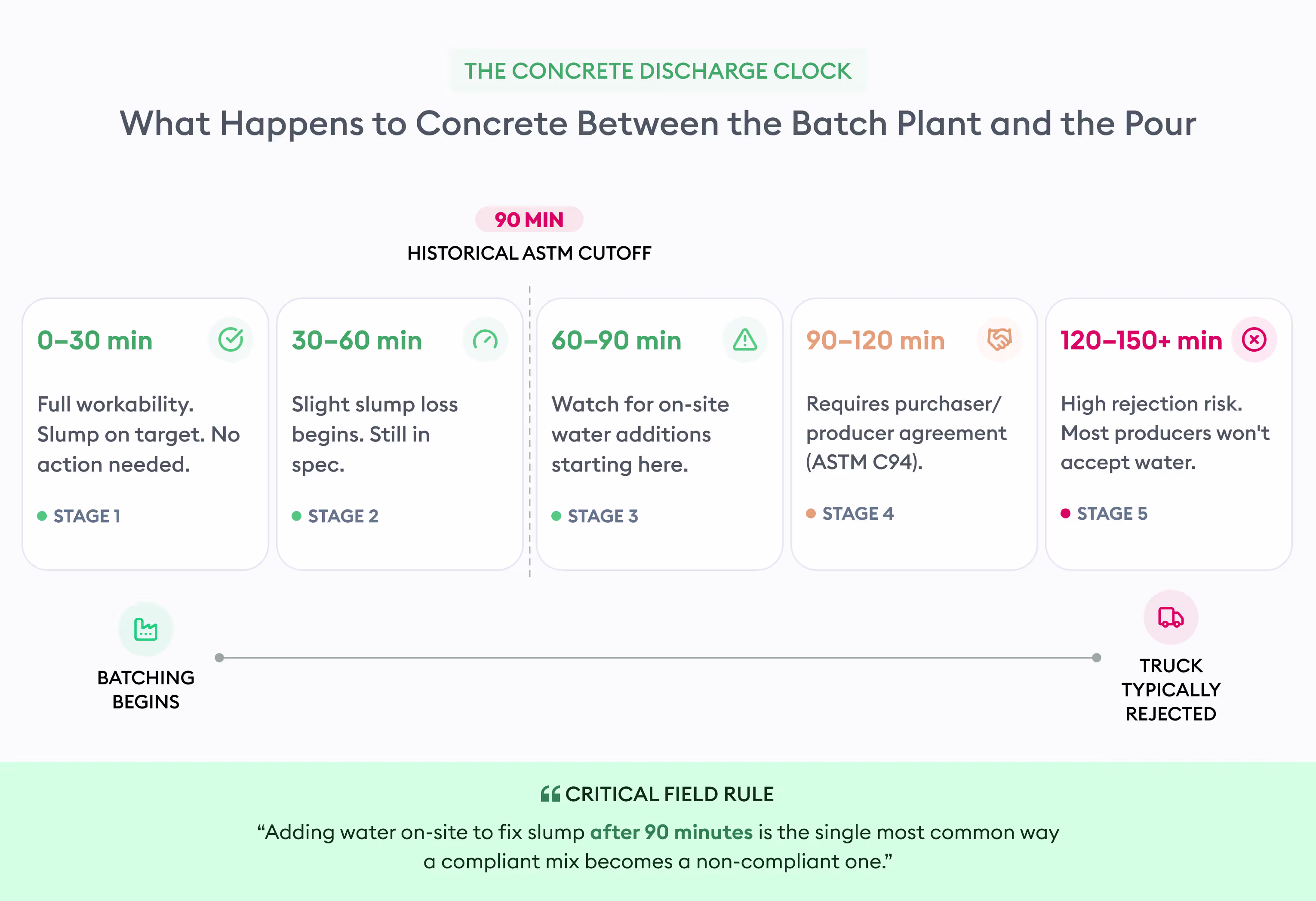

concrete discharge clock - beam ai

Missing MEP Embedments

A pour can look completely perfect on the surface. Yet, it may still have a problem if something underneath was missed.

  • The issue: pouring over missing utility sleeves, anchor bolts, or conduit knockouts that were left off the layout or installed in the wrong position.
  • What inspectors look for: pre-pour mechanical, electrical, and plumbing sign-offs, correct anchor bolt placement against the structural plan, and sleeve integrity before concrete covers them permanently.

Inadequate Equipment and Weather Planning

A good mix and well-prepared formwork can still go wrong if the crew isn’t ready to place and protect the concrete properly once it gets to the site.

  • The issue: Absence of a backup vibrator at the job site can lead to honeycombing or create trapped air pockets. Poor planning for hot weather, cold weather, or rain can also affect the concrete during placement and early curing.
  • What inspectors look for: A clear concrete pouring plan, working vibration equipment, and protection such as thermal blankets or evaporation retarders, all in place before the first truck arrives.

The Real Cost of a Failed Pour

Category Preventative Measure Cost Cost of Inspection Failure and Rework
Labor and Crew Standard shift pay Roughly double: demolition crew plus retested re-pour crew
Materials Target mix design, priced once Wasted batch concrete plus demolition disposal fees
Equipment Daily pump and vibrator rental Truck standby fees ($150 to $300+ per hour) plus a second pump mobilization
Timeline Impact On-schedule completion 3 to 10-day delay per failed hold point, plus downstream trade slippage

The cost to pour concrete slab the first time is a known, budgeted number, and the cost to pour concrete pad follows the same logic on a smaller scale. The cost of doing either one twice rarely is since standby fees, disposal, and schedule slip are not usually built into the original estimate.

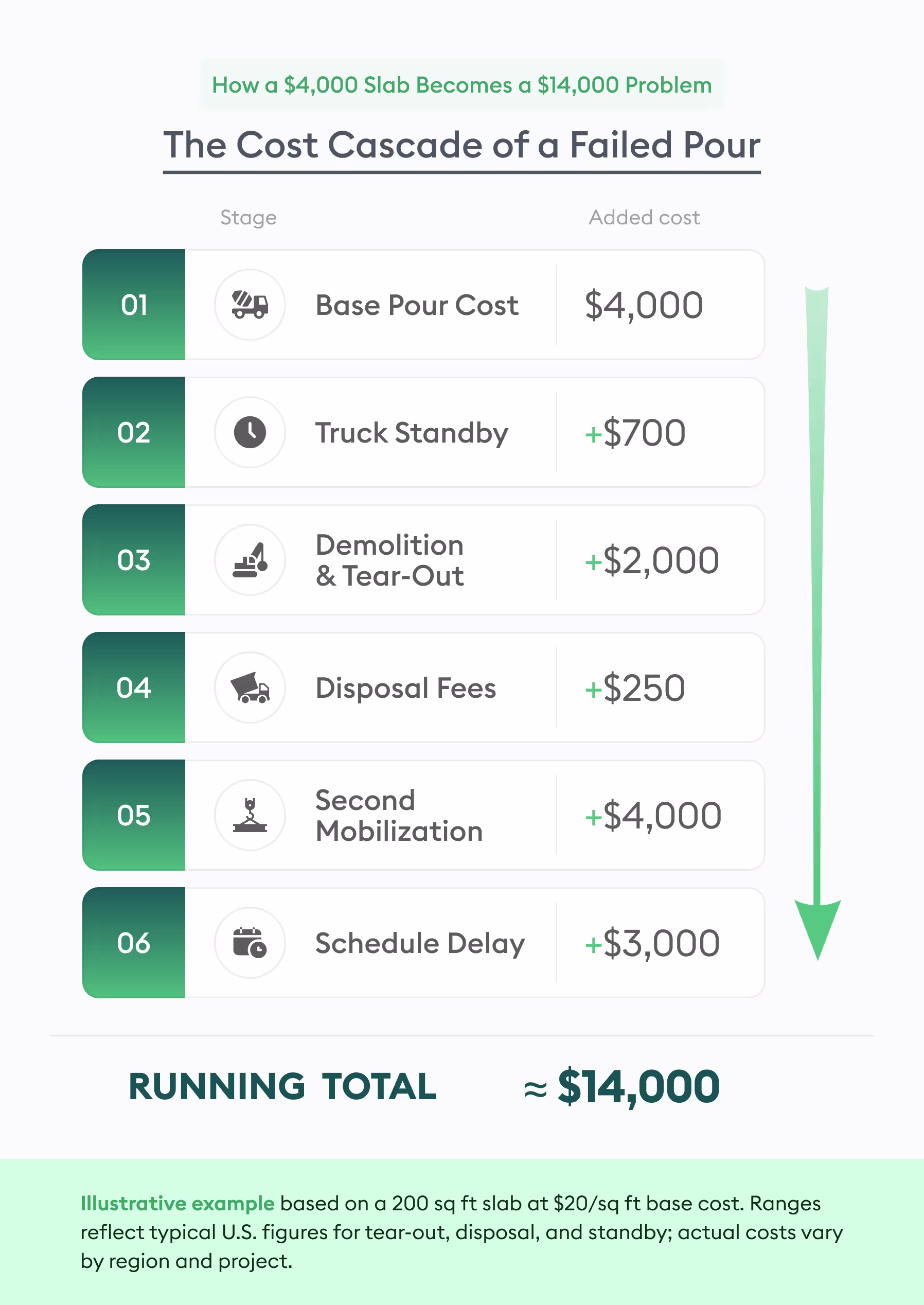

cost cascade of a failed pour - beam ai

How to Guarantee a Passing Inspection: The Pre-Pour Checklist

  • Review approved drawings 24 hours prior. Make sure the structural and MEP sets present on-site match the current revision of the designs, not an earlier version that is still in a crew truck.
  • Check and verify rebar elevation, spacing, and cover chairs. Walk the reinforcement with a tape and a cover meter instead of eyeballing spacing against the drawings.
  • Sweep forms clean before close-up. Remove trash, tie wire, and debris that would otherwise sit inside the finished slab.
  • Make sure the batch mix design complies with the requirements of the task. Make sure to check the delivery ticket for the approved mix design before the pouring process starts.
  • Stage field QA testing gear in advance. Slump cone, cylinder molds, and thermometers should be on-site and ready before the first load arrives.
  • Run a formal internal walkthrough before the special inspector shows up. A five-minute crew walk can catch and resolve most of the issues that would otherwise be flagged during a formal inspection.

In Closing

Passing inspection comes down to doing the same six checks before every concrete pouring job: formwork, reinforcement, subgrade, mix design, embedments, and equipment. Do that every time, and you’re far less likely to run into problems later.

The good news is that most of these issues are easy to spot before the pour. A quick rebar cover check, comparing the batch ticket with the mix design, or spending five minutes clearing debris from the forms can make quite a big difference. These checks take little time and are far cheaper than finding a problem after the concrete is already in place. When crews skip these steps, it's often due to a very tight schedule. And if there's no time for such basic checks, it usually indicates the real issue has already taken root well before the pour.

A concrete pouring plan that's built on guessed quantities puts a crew in a bad spot right from the jump. Maybe the slab is thicker than what the structural drawings specify, or the rebar schedule was based on a similar job instead of the actual plans. Now the crew is left trying to fix an issue in the field that should have been caught early on paper in the first place.

This is where accurate takeoff comes into the picture, and this is also where their work really pays off. Concrete takeoff and estimating software gives crews key numbers upfront, including slab thickness, reinforcement, and pour volume, all pulled directly from the plans. Nothing is based on guesswork. Since those numbers come straight from the plan, the pre-pour checklist becomes a quick run-through item instead of a last-minute scramble.

Beam AI's takeoff workflow pulls those numbers directly from uploaded drawings, so the estimator, the PM, and the crew on site are all working from the same figure instead of three different guesses.

SHARE TO

Riya Trehan

Senior Analyst - Product & Content

About Author

Riya is a construction-focused writer who brings a sharp editorial eye and deep industry knowledge to clear, purposeful writing.

About Author

The Ultimate Guide to Construction Cost Estimating

Download eBook →

FAQs

What is the most common reason concrete pouring fails inspection?

Chevron down blue

Mix design and slump problems are some of the most common issues, often caused by a truck arriving too late or extra water being added on-site to make the concrete easier to work with. Both alter the water-cement ratio the mix was engineered around, and the resulting strength loss does not show up until cylinder breaks come back weeks later.

Does dry pour concrete ever pass a structural inspection?

Chevron down blue

Almost never. Dry pour placement hydrates unevenly because water has to soak down through the dry mix instead of being blended in, and it cannot reliably reach code-minimum compressive strength beyond a couple of inches of thickness. Most inspectors will reject it outright for any pour that requires a permit.

How much does it cost to pour a concrete slab or pad the first time versus after a failed inspection?

Chevron down blue

A slab or pad that passes inspection is paid for once. A failed inspection can quickly add costs for truck standby time, demolition and disposal, and another mobilization. It can also push the schedule back by 3 to 10 days for each failed hold point, adding more cost on top of the original pour.

How much rebar cover is required in a concrete slab or footing?

Chevron down blue

Cover requirements vary by exposure condition and structural element. Concrete cast directly against soil carries one of the strictest requirements in the code, a minimum of three inches, while other conditions call for less. Project drawings should always specify the exact figure rather than relying on a general rule of thumb.

Can better estimating actually prevent inspection failures?

Chevron down blue

Yes, indirectly. When slab thickness, rebar quantities, and pour volume are worked out before bid day, the crew has a plan. One that's based on the actual structural drawings, and not a field estimate. Concrete takeoff software and concrete estimating software remove much of the guesswork that leads to under-scoped rebar, mismatched mix designs, and concrete pouring schedules that cannot keep pace with the truck.

Latest Articles

Electrical Panel Schedule

Insight

4 mins read

How to Read an Electrical Panel Schedule

Natasha Ao

&

Read blog →

Float in a Construction Schedule - beam ai

Insight

4 mins read

Who Actually Owns the Float in a Construction Schedule

Mridula Joshi

&

Read blog →

BIM

5 mins read

BIM Maturity Levels 0 to 3: What Each One Means and How to Tell Where You Stand

Muskaan Sharma

&

Read blog →

Experience the Best Takeoff Software for Estimators

Talk to us and get your first AI takeoff done at no cost!

Get a Step-by-Step Beam AI Walkthrough
Fill out this form and see how easy it is to set up takeoffs, export reports, and get ready-to-use quantities.
Cancel
Note: After submitting the form, a Beam AI specialist will follow up to explore how AI takeoffs can boost your estimating efforts.
