What Topsoil Stripping Adds to an Earthwork Estimate

5 mins read

September 12, 2026

Construction Estimation
Blogs

>

Construction Estimation

>

Key Takeaways

  • Topsoil stripping should be tracked separately from structural cut-and-fill because stripped organic material is generally unsuitable for structural fill.
  • Topsoil volume can be calculated using Area × Depth ÷ 27 to convert cubic feet to cubic yards.
  • A typical stripping depth may be around 4–12 inches, but project specifications or geotechnical information should determine the actual depth.
  • Stockpiling adds equipment, labor, space, and handling costs.
  • If stripped material cannot be reused, the estimate needs to include topsoil haul-off and disposal.
  • If stripping creates a structural fill deficit, imported fill may also be required.
  • Stripping should use its own production-rate assumptions rather than mass-excavation rates.

Summary

Topsoil stripping is more than a preliminary site-clearing activity. It creates a separate excavation quantity, adds handling costs, and can change the site's cut-and-fill balance. Because organic-rich topsoil is generally not suitable for structural fill, it needs to be accounted for separately in an earthwork estimate. This blog explains how topsoil stripping affects an estimate, how to calculate topsoil volume, and what to include for stockpiling, haul-off, imported fill, and respreading.

What Is Topsoil Stripping?

Topsoil stripping is the removal of the organic-rich surface layer of soil from areas that will be disturbed during construction.

The material is normally removed before grading, excavation, building construction, paving, or other earthwork. Depending on the project, it may be stockpiled for landscaping, reused elsewhere on-site, or hauled away.

The required depth varies by project. Specifications, geotechnical information, or field conditions may call for 4, 6, 8, 12 inches, or another depth.

That matters because even a few inches across a large commercial or civil site can create thousands of cubic yards of material.

For an estimator, the key point is that topsoil is a separate material stream, not simply another part of structural excavation.

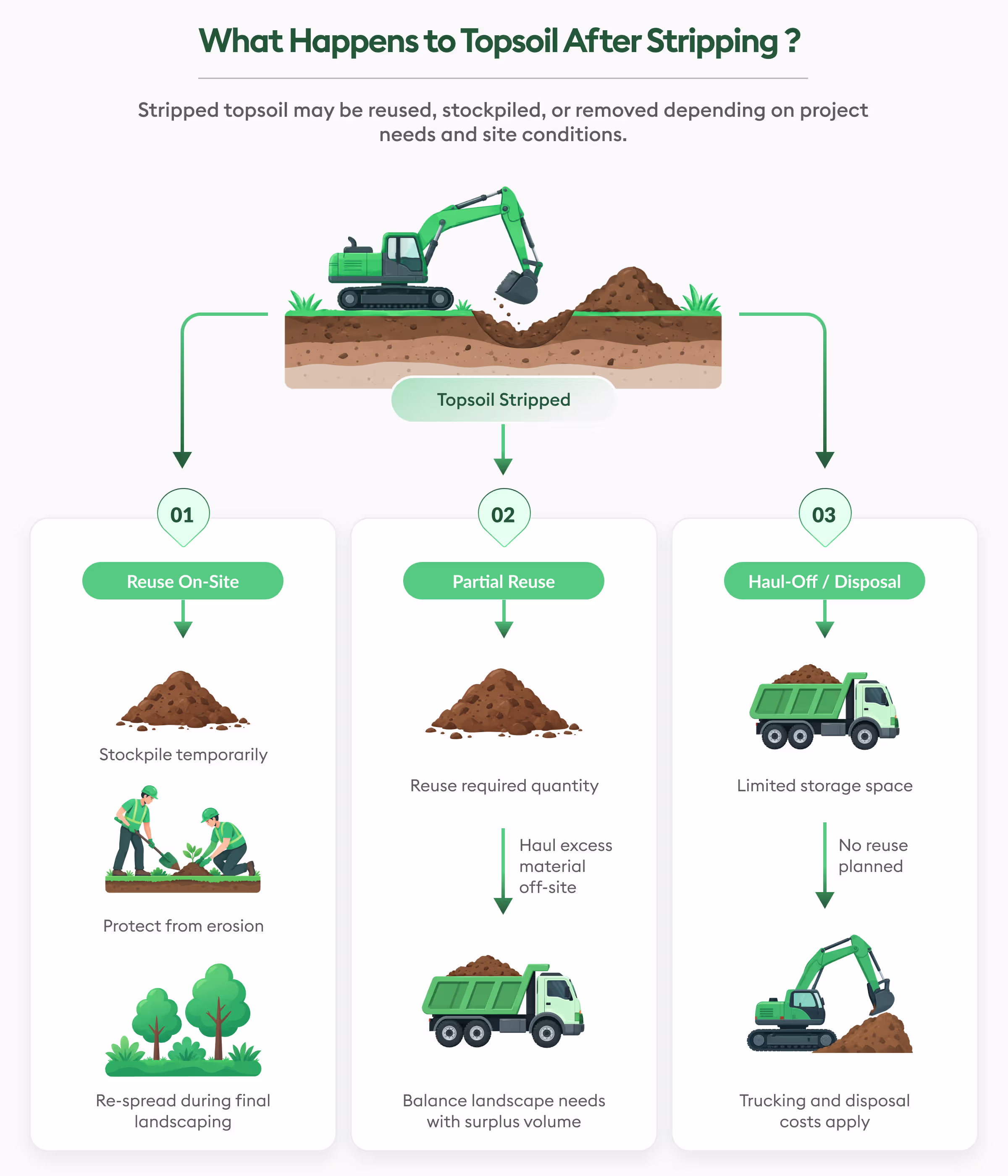

what happens to topsoil after stripping

Why Topsoil Stripping Is Separate From Cut-and-Fill

Topsoil stripping is not the same thing as structural cut-and-fill. The two operations move different types of material and serve different purposes.

Topsoil contains organic matter and is intended primarily as a growing medium. EPA guidance notes that because of its high organic content, topsoil cannot be used as fill material or under pavement. Instead, it is typically stockpiled and reapplied later for revegetation.

Structural cut-and-fill, on the other hand, deals with material that can be excavated, transported, placed, and compacted to meet the project's requirements.

This means an estimator shouldn't simply take the existing-ground surface and calculate cut and fill as though the topsoil were usable structural material. Instead, the workflow is closer to: Existing ground → Topsoil stripping → Structural cut/fill → Final grading → Topsoil respread

And this is important because removing topsoil can change the amount of usable material available for structural earthwork.

Topsoil stripping is only one piece of the larger earthwork picture. Here’s what goes into a complete earthwork takeoff.

Book a personalized demo

See how Beam AI fits into your estimating workflow. Get a tailored walkthrough based on your trade, project volume, and current takeoff process.

Schedule a demo →

How Topsoil Stripping Changes an Earthwork Estimate

Topsoil stripping can affect an estimate in several different ways.

It adds a separate excavation volume

The first addition is straightforward: the estimator has to quantify the material being stripped.

The basic formula is: Topsoil Volume (CY) = Area (SF) × Stripping Depth (ft) ÷ 27

For example, consider a 2-acre site where the disturbed area is stripped to 6 inches.

Convert the area: 2 acres × 43,560 SF = 87,120 SF

Convert the stripping depth: 6 inches ÷ 12 = 0.5 ft

Then calculate the volume: 87,120 × 0.5  ÷ 27 = 1,613 CY

So a 2-acre site stripped 6 inches deep produces approximately 1,613 cubic yards of topsoil before any applicable adjustments for actual site boundaries, unsuitable material, or material behavior.

That's a substantial quantity to account for, and it should be tracked separately from structural cut-and-fill. The reason is simple: those 1,613 CY cannot automatically be treated as 1,613 CY of usable structural fill.

It can change the cut-and-fill balance

This is one of the easiest effects to overlook.

Suppose a grading plan appears to have a relatively balanced amount of cut and fill. If the topsoil is stripped first and cannot be used as structural fill, the amount of usable material available for the structural earthwork can change.

In other words, the site may look balanced on a raw surface comparison but become a fill deficit after topsoil is removed.

Current earthwork software workflows explicitly recognize this interaction. Topsoil depth can affect the surface used for cut-and-fill calculations, changing the resulting cut-and-fill quantities.

That's why estimators should ask:

  • How much topsoil is being stripped?
  • How much can be reused?
  • Is it permitted as fill anywhere on the project?
  • How much structural fill remains available after stripping?
  • Will imported fill be required?

This is why topsoil should be segregated from raw earthwork quantities rather than simply incorporated into a total cut number.

The key is knowing what each material can actually be used for. Here’s a closer look at the differences between backfill, fill dirt, and topsoil.

It adds stockpiling and handling costs

Stripping isn't simply an excavation quantity. Someone, or something, has to move the material.

If the project calls for strip and stockpile, the estimate may need to account for:

  • Excavator, loader, or dozer time
  • Loader time
  • Labor
  • Short-haul movement
  • Stockpile shaping
  • Stockpile protection
  • Erosion and sediment controls
  • Additional site space
  • Rehandling during final placement

Stockpile location matters, too.

A stockpile that is close to the stripping area may require relatively little movement. If available space is on the opposite side of the site, however, the same topsoil quantity can require significantly more equipment time and haul distance.

Recent construction specifications also emphasize keeping topsoil separate from subsoil and properly managing stockpiles to protect them from erosion and maintain surface drainage.

So topsoil stripping cost isn't just: CY × stripping unit price

The unit cost needs to reflect the actual handling scenario.

It can add topsoil haul-off costs

Not every project has enough space, or enough future landscaping demand, to reuse all stripped topsoil.

If there isn't enough landscaping area, adequate stockpile space, or another approved use, the estimator needs to determine how much topsoil leaves the site. And that creates another cost stream: Topsoil haul-off = Volume × trucking cost + disposal/tipping fees

The actual cost depends on factors such as:

  • Haul distance
  • Truck capacity
  • Number of trucks required
  • Loading time
  • Cycle time
  • Disposal or receiving-site fees
  • Local restrictions on soil disposal
  • Whether the material meets receiving-site requirements

This means a topsoil quantity should never be considered complete until the estimator knows where the material is going, particularly when a project has a large disturbed footprint but limited landscape area.

It may create an imported-fill cost

Here's the double-hit that can get missed in an earthwork estimate.

Imagine the project strips 1,600 CY of topsoil. The estimator now has two separate questions:

  • What will it cost to handle or dispose of the 1,600 CY of topsoil?
  • Does removing that material create a structural fill deficit?

If the answer to the second question is yes, the contractor may have to purchase and haul in approved structural fill.

That means the estimate could include both topsoil haul-off + imported structural fill

The two quantities may not be exactly equal because the project's cut-and-fill balance, material suitability, shrink/swell, compaction requirements, and final grades all affect the calculation.

This is why simply including a topsoil stripping quantity isn't enough. The estimator needs to carry that quantity through the entire earthwork balance.

It requires different production rates

Topsoil stripping shouldn't automatically use the same production assumptions as mass excavation.

The operation is different.

During stripping, the contractor is generally trying to remove a relatively shallow layer while minimizing contamination with the underlying subsoil. Specifications commonly require topsoil to be stripped separately and handled carefully to prevent intermixing.

Production can therefore depend on:

  • Stripping depth
  • Soil moisture
  • Equipment type
  • Push distance
  • Loading conditions
  • Haul distance
  • Stockpile location
  • Site congestion
  • Whether clearing and grubbing are complete
  • Whether the material is being stockpiled or loaded directly into trucks

A mass excavation production rate may assume a deeper excavation and a different loading/hauling cycle.

Applying that rate blindly to shallow topsoil stripping can distort labor and equipment costs.

How to Estimate Topsoil Stripping Step by Step

A repeatable process makes it easier to avoid missed quantities and hidden costs.

Determine the stripping depth

Start with the project specifications, geotechnical report, soil investigation, or other project documentation.

Don't assume a standard depth. A project might specify 4, 6, 8, 12 inches, or another depth based on actual soil conditions, while some specifications also require deeper layers to be treated separately.

Measure the disturbed area

Identify the portions of the site that actually require stripping, i.e., areas where topsoil needs to be removed.

This could include building pads, roads, parking areas, utility corridors, and other construction or grading areas.

Avoid automatically applying the stripping depth to the entire property if only part of the site will be disturbed.

Calculate topsoil volume

Use: Area (SF) × Depth (ft) ÷ 27 = Topsoil CY

For example: 87,120 SF × 0.5 ft ÷ 27 = 1,613 CY

Record the area and depth assumptions with the quantity so they can be reviewed later.

Decide whether to reuse or haul off

Determine what happens to the stripped material. Typical options include:

  • Stockpile and reuse
  • Stockpile and respread later
  • Direct reuse elsewhere on the site
  • Partial reuse and partial haul-off
  • Complete off-site disposal

Specifications may also distinguish usable topsoil from unsuitable or surplus material.

Adjust the cut-and-fill balance

Remove unusable topsoil from the pool of material available for structural earthwork and then determine whether the project remains balanced or requires imported fill.

Apply stripping-specific production rates

Estimate equipment and labor based on the actual stripping operation. Consider both the excavation cycle and the movement to the stockpile or truck.

Add stockpile handling and respreading

If topsoil is being reused, the work isn't finished after the initial strip. You need to include the second handling cycle as well.

The estimate may also need to include: Stockpile → Rehandle → Load → Transport → Spread → Finish

A complete respread topsoil estimate should therefore include the equipment and labor needed to return the material to finished landscape areas.

Take a Free Product Tour

Explore Beam AI with an interactive walkthrough. Check out the simple 4-step takeoff submission process and how you can export quantities with ease.

Experience Beam AI →

What Should a Topsoil Line Item Include?

A useful earthwork estimate can break the operation into separate components rather than burying everything inside one earthwork number.

Estimate item What it covers
Topsoil stripping Removing the specified topsoil depth
Loading / Handling Loading and moving stripped material
Stockpiling Creating and maintaining temporary stockpiles
Stockpile protection Erosion/sediment control where required
Topsoil haul-off Transporting surplus topsoil off-site
Disposal Receiving-site or tipping fees
Imported fill Replacement structural fill if stripping creates a deficit
Topsoil respread Returning salvaged material to finished landscape areas
Imported topsoil Additional topsoil if salvaged topsoil is insufficient

This separation makes the estimate easier to review, makes scope gaps easier to identify, and reduces the chance that handling or replacement costs disappear from the bid.

Common Topsoil Stripping Estimating Mistakes

Treating topsoil as ordinary cut - This can overstate the amount of usable structural material.

Assuming the entire property needs stripping - Only the area requiring disturbance should generally be included unless the specifications say otherwise.

Using a standard stripping depth - Use the project-specific depth from specifications or site information.

Forgetting stockpile movement - Keeping material on-site still requires equipment, labor, and space.

Pricing haul-off without checking reuse - Determine whether the project requires preservation and reuse before assuming all topsoil leaves the site.

Forgetting replacement fill - This is perhaps the most expensive mistake. If stripping creates a fill deficit, imported structural material may become another project cost.

Using mass-excavation production rates - Shallow stripping and bulk excavation are different operations and should be modeled accordingly.

How Better Takeoffs Help Capture Topsoil

Topsoil stripping is a good example of why an earthwork takeoff needs to capture more than a single cut-and-fill number. The estimator needs to interpret:

  • Existing conditions
  • Proposed grading
  • Disturbed areas
  • Stripping depths
  • Soil information
  • Stockpile requirements
  • Landscape areas
  • Notes and specifications

Beam AI's current earthwork workflow, for example, identifies cut/fill, topsoil stripping, trench excavation, and erosion-control quantities as separate scope elements when processing civil and grading plans.

A good earthwork takeoff should account for all of these scope elements, not just cut and fill. Explore the features that can help.

Accurate takeoffs, however, don't replace estimator judgment. They give the estimator a cleaner quantity base from which to make pricing and production decisions.

Final Thoughts

Topsoil stripping may occur before the main earthwork begins, but it can have a meaningful effect on the final estimate.

The stripped material represents a separate excavation quantity. It may require stockpiling, handling, haul-off, disposal, imported structural fill, and eventual respreading. More importantly, because organic-rich topsoil is generally unsuitable for structural fill, stripping can change the project's usable cut-and-fill balance and create a need for imported material.

The best approach is to treat topsoil as its own material stream:

Measure it → calculate the volume → determine reuse or disposal → adjust cut and fill → price handling → account for import or haul-off → price respreading.

When those steps are incorporated into the earthwork estimate from the start, estimators have a more complete picture of the project's actual material movement and cost and the final bid is much less likely to be missing the small line item that turns into a much larger cost in the field.

SHARE TO

Muskaan Sharma

Senior Analyst - Product Marketing

About Author

Muskaan is a construction-focused product marketer who combines industry understanding with a clear, practical writing style.

About Author

The Ultimate Guide to Construction Cost Estimating

Download eBook →

FAQs

What does it mean to strip topsoil?

Chevron down blue

Topsoil stripping is the removal of the organic-rich surface layer of soil from areas that will be disturbed during construction. The material can be stockpiled for reuse, reused elsewhere on-site, or hauled away.

How heavy is 1 cubic metre of topsoil?

Chevron down blue

The weight of topsoil varies depending on its moisture content, density, and composition. As a general estimating range, 1 cubic metre of topsoil weighs roughly 1.2-1.7 metric tonnes. Wet or compacted topsoil can weigh considerably more than dry, loose material, so project-specific material information should be used when haulage or trucking costs are being estimated.

What is the process of removing topsoil called?

Chevron down blue

The process is called topsoil stripping. It involves removing the specified depth of organic topsoil from the areas that will be disturbed by construction, typically before grading or mass excavation begins.

How do you calculate topsoil?

Chevron down blue

To calculate the volume of topsoil to be stripped, multiply the area by the stripping depth and divide by 27 when working in square feet and feet:

Topsoil Volume (CY) = Area (SF) × Depth (ft) ÷ 27

For example, a 2-acre site stripped to 6 inches produces approximately 1,613 cubic yards of topsoil.

Is topsoil included in cut-and-fill calculations?

Chevron down blue

Topsoil should generally be tracked separately from structural cut-and-fill because organic topsoil is usually unsuitable for structural fill. Removing it can also change the site's usable cut-and-fill balance.

What does topsoil stripping cost include?

Chevron down blue

Costs can include stripping, equipment and labor, loading, movement, stockpiling, haul-off, disposal, imported fill, and eventual respreading.

Why can topsoil stripping create both haul-off and import costs?

Chevron down blue

If stripped topsoil cannot be reused, the contractor may pay to haul and dispose of it. If removing that material also creates a structural fill deficit, the contractor may then need to purchase and haul approved fill onto the site. These are two separate cost impacts.

Latest Articles

Insight

5 mins read

Concealed vs. Exposed Ductwork Cost: What estimators need to know

Ura Verma

&

Read blog →

cloud based systems

Insight

4 mins read

How Do Cloud-Based Systems Safeguard Takeoff Data and Project Files?

Shivangi Ojha

&

Read blog →

Estimate HVAC Equipment from Mechanical Schedules

Construction Estimation

4 mins read

How to Estimate HVAC Equipment from Mechanical Schedules

Riya Trehan

&

Read blog →

Experience the Best Takeoff Software for Estimators

Talk to us and get your first AI takeoff done at no cost!

Get a Step-by-Step Beam AI Walkthrough
